Resource Calendar

Make Saturday a Working Day in Microsoft Project

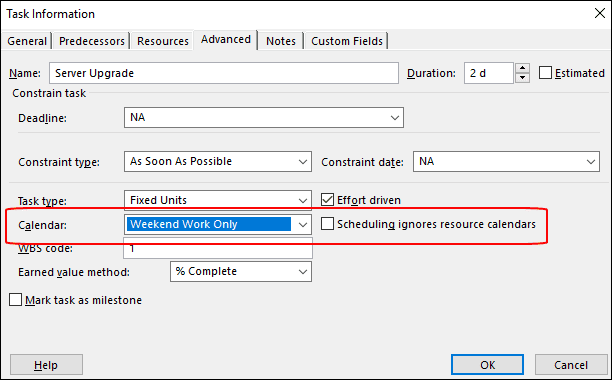

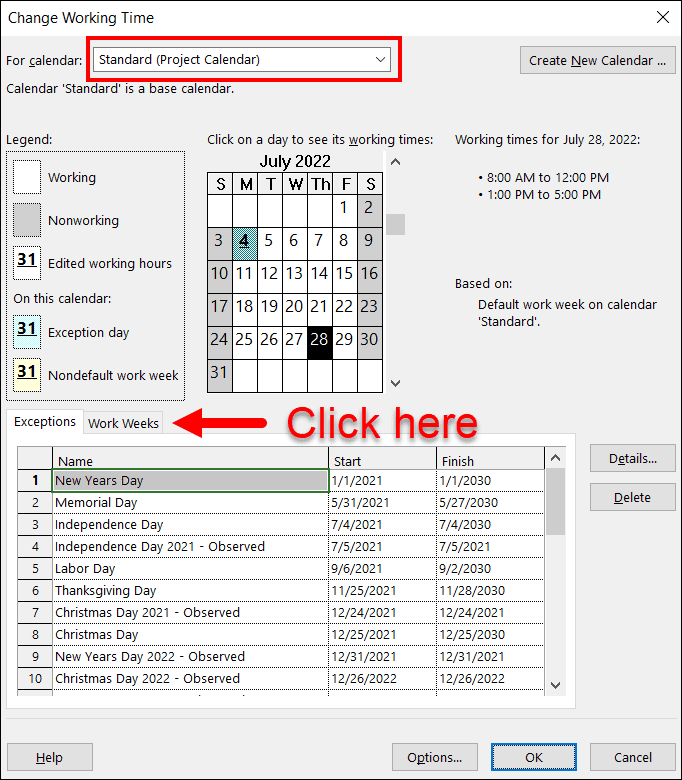

Background There was an interesting question recently in the Tech Community Project user forum. A user asked how to change the default working calendar to allow Saturday as a working day. The question...

A Better Microsoft Project: Workload Levelling and Resource-Critical Path

Most projects are logic-constrained projects (or, if I might suggest, wrongfully treated as such). A logic-constrained project has a duration only determined by logic (i.e., the network of dependencie...

A Better Microsoft Project for Time Modeling: Deadlines and the (Most‑) Critical Path

In my previous post, I explained that I’d be making a case in a series of articles for adding certain features to Microsoft’s Project for Desktop and Project for the web software. Here, I’d like to su...

Ten Best Microsoft Project Tips –Transcription

Please find below a transcription of the audio portion of Praveen Malik’s webinar, Ten Best Microsoft Project Tips, being provided by MPUG for the convenience of our members. You may wish to use this ...

Critical Path Modeling Using Microsoft Project: Lesson 3 – Leveling and Resolving Resource Conflicts Transcription

Please find below a transcription of the audio portion of Sam Bell’s course, Critical Path Modeling Using Microsoft Project (Lesson 3: Leveling and Resolving Resource Conflicts), being provided by MPU...

Critical Path Modeling Using Microsoft Project: Lesson 2 – Leveraging Work and Predecessor Types to Structure the Plan Transcription

Please find below a transcription of the audio portion of Sam Bell’s course, Critical Path Modeling Using Microsoft Project (Lesson 2: Leveraging Work and Predecessor Types to Structure the Plan), bei...

Critical Path Modeling Using Microsoft Project: Lesson 1 – Estimating Resources and Using Resource Calendars Transcription

Please find below a transcription of the audio portion of Sam Bell’s course, Critical Path Modeling Using Microsoft Project (Lesson 1: Estimating Resources and Using Resource Calendars), being provide...

Critical Path Modeling Using Microsoft Project: Lesson 1 Estimating Resources and Using Resource Calendars

Event Description: This course provides an overview of how to manage a project’s resources, timeline and cost through effective critical path modeling using Microsoft Project. This step by step ...

The Close Sibling of Communications and Stakeholder Management: Resource Management

In one of my earlier articles, The Twins–Communications and Stakeholder Management, I outlined how deeply and closely these two knowledge areas of the PMBOK® guide interact with each other. We saw a g...
